TeraWulf (WULF) Deep Research — Bilingual Edition
1st edition · EN + ZH PDFs · 12 figures, 56 tables · three-horizon view · Target-price analysis
- Type
- Company
- Series
- WULF
- Data as of
- 2026-09-09
- Pages
- 81
- Format
- Category
- Research Reports
- Delivery
- File download delivery
- Publisher
- TopxAI Research
- Listing updated
- 2026-09-11
Sample
8 of 81 pagesDescription
TeraWulf Inc. (Nasdaq: WULF) company deep dive, first edition. Two PDFs — Chinese (67 pp) and English (81 pp) — each with 16 chapters plus 4 appendices, 12 figures and 56 data tables, cell-for-cell consistent across the two versions; every computed figure is derived in Appendix D. Reference date: close of 9 September 2026; financials as of 30 June 2026.

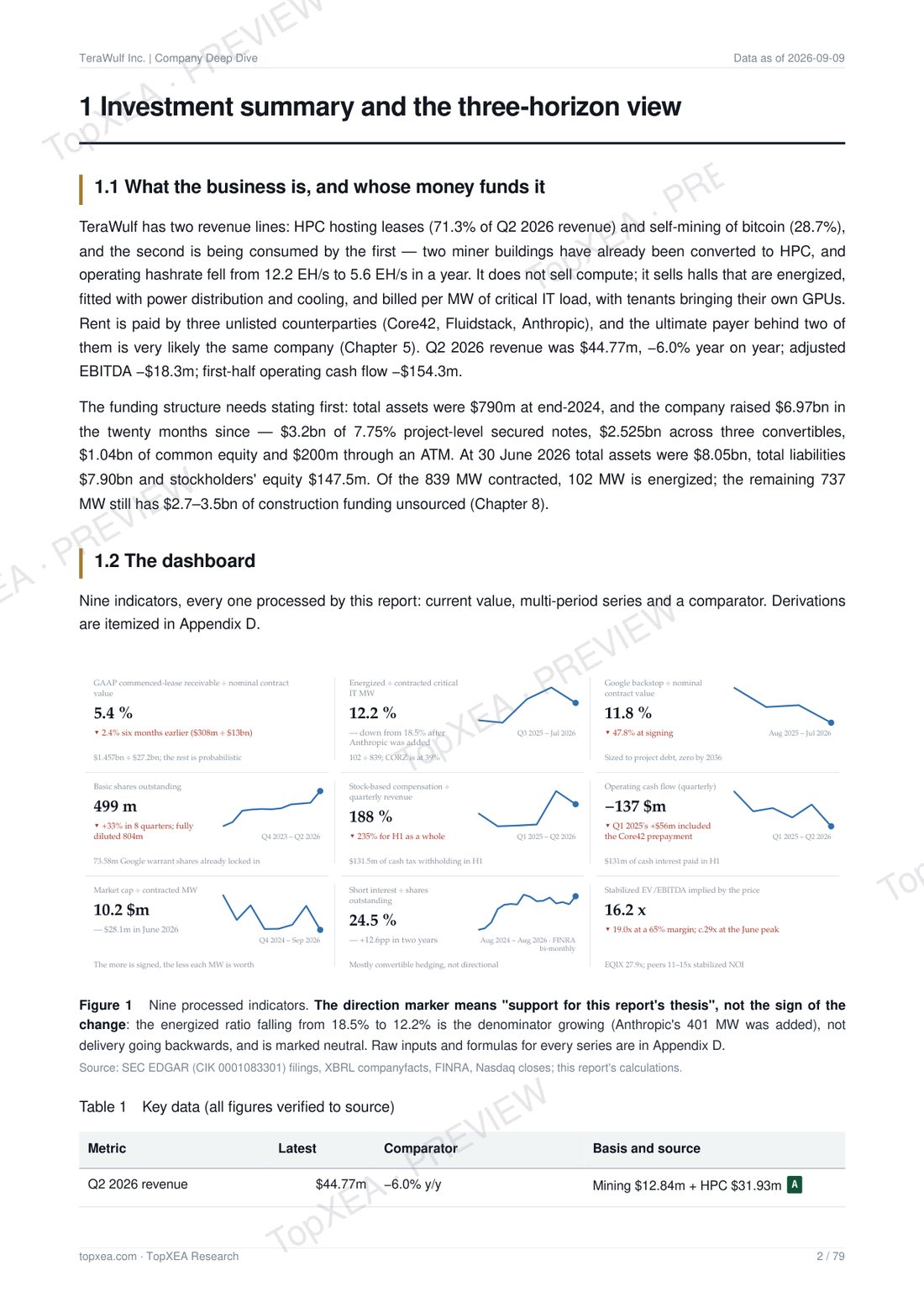

In twenty months the company turned itself from a bitcoin miner into a development-stage landlord of AI compute halls: $27.2bn of leases signed, $6.97bn raised, 73,580,000 penny warrants issued to Google. This report measures the distance between "signed" and "built": only $1.457bn (5.4%) is settled in the accounts, 102 MW (12%) is energized and billing, the remaining 737 MW needs $5.7–6.5bn with a $2.7–3.5bn gap; the Google backstop is sized to project debt, reaches zero in 2036 and covers 11.8% of contract value; Anthropic's $19bn shows no executed credit enhancement in the filings.
What the report delivers
| Chapter | Specific result |
|---|---|

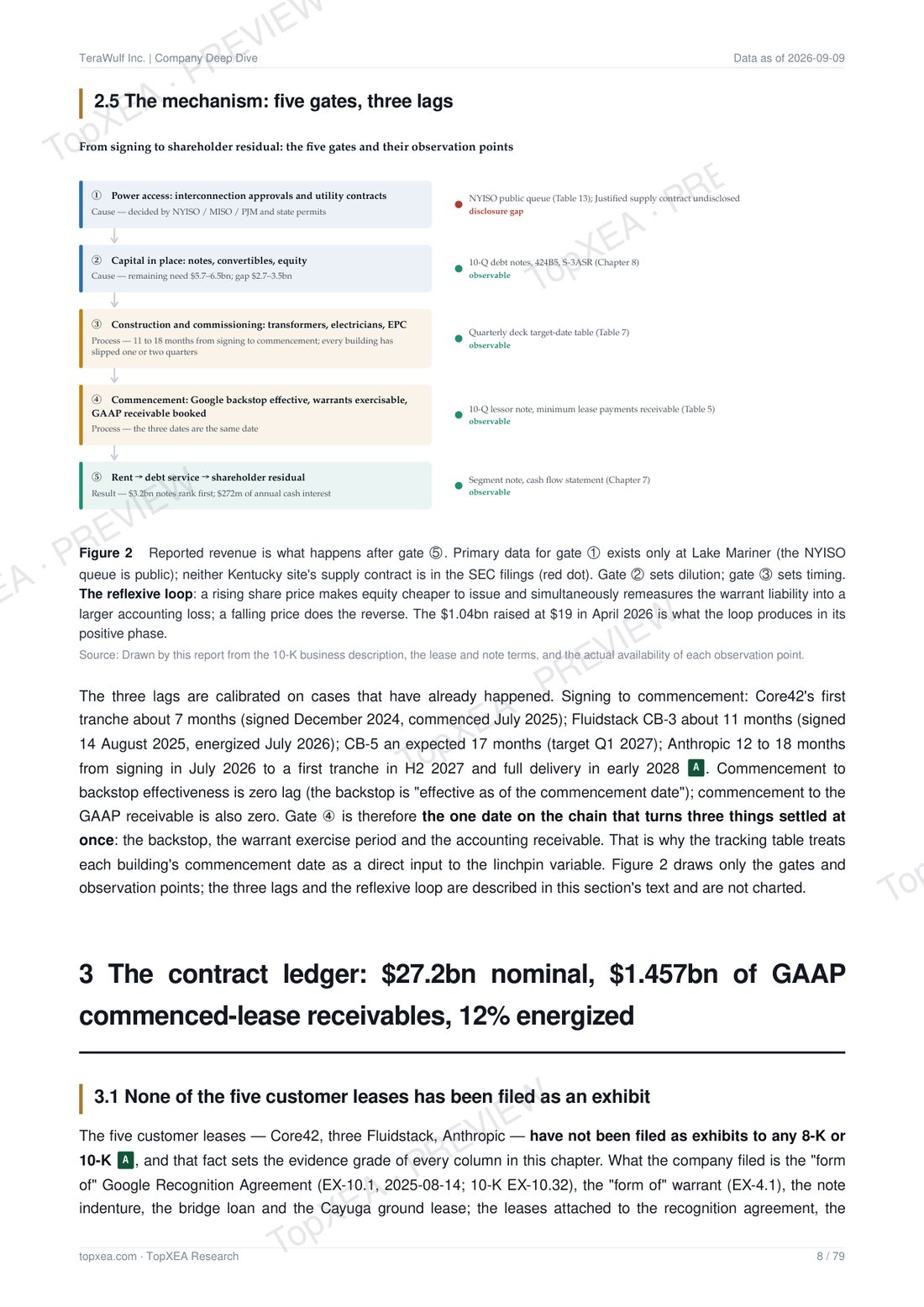

| 3 | The contract ledger: five unfiled leases reconstructed one by one; how contract value is computed; GAAP commenced-lease receivable ÷ nominal value = 5.4%; the three states of capacity and each building's target-date drift |

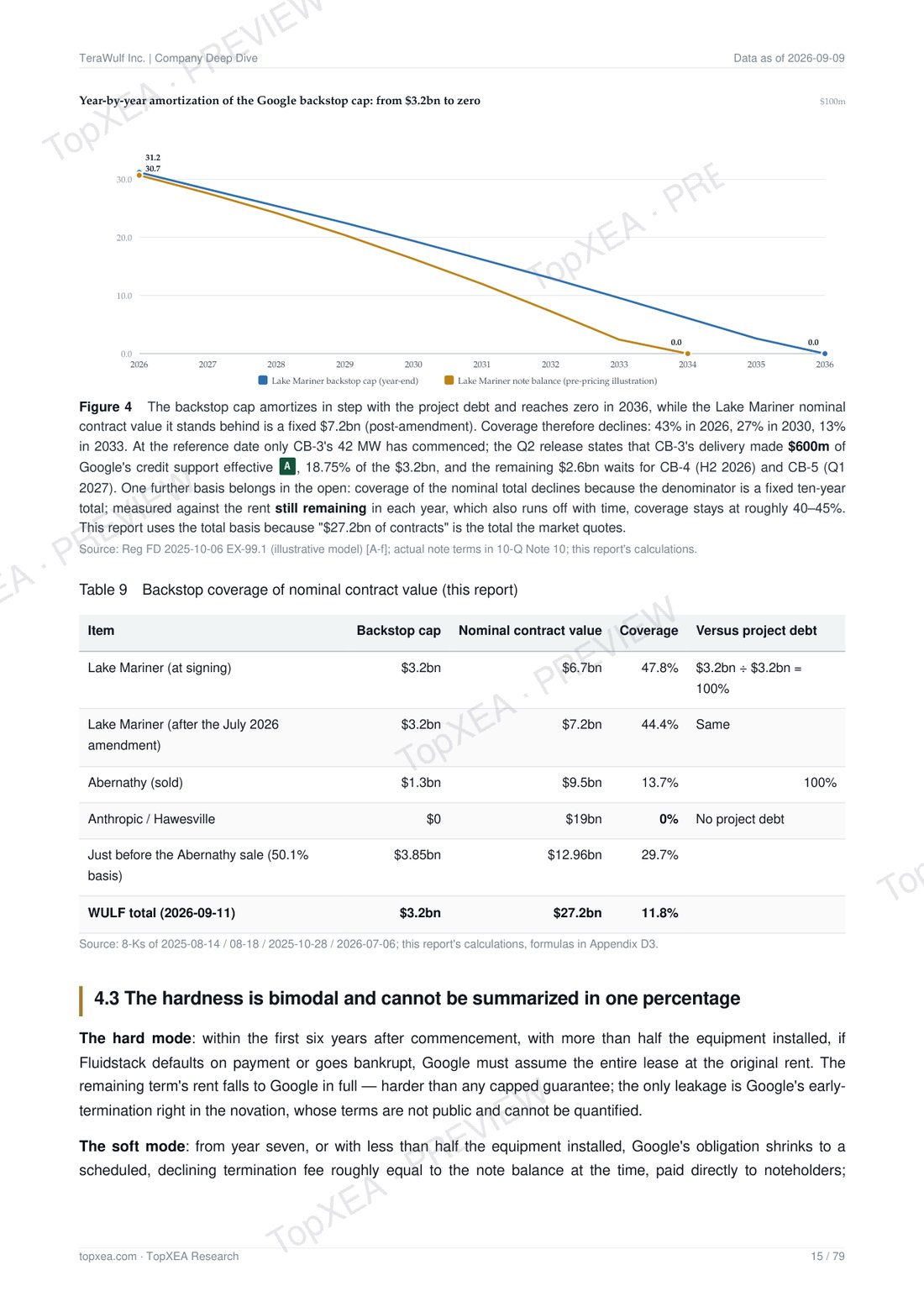

| 4 | The Google recognition agreement clause by clause: triggers, three options, the six-year assumption obligation, where the fee goes; the year-by-year backstop amortization and coverage from 47.8% to 11.8%; warrant terms (exercisable before commencement, anti-dilution, pledge) |

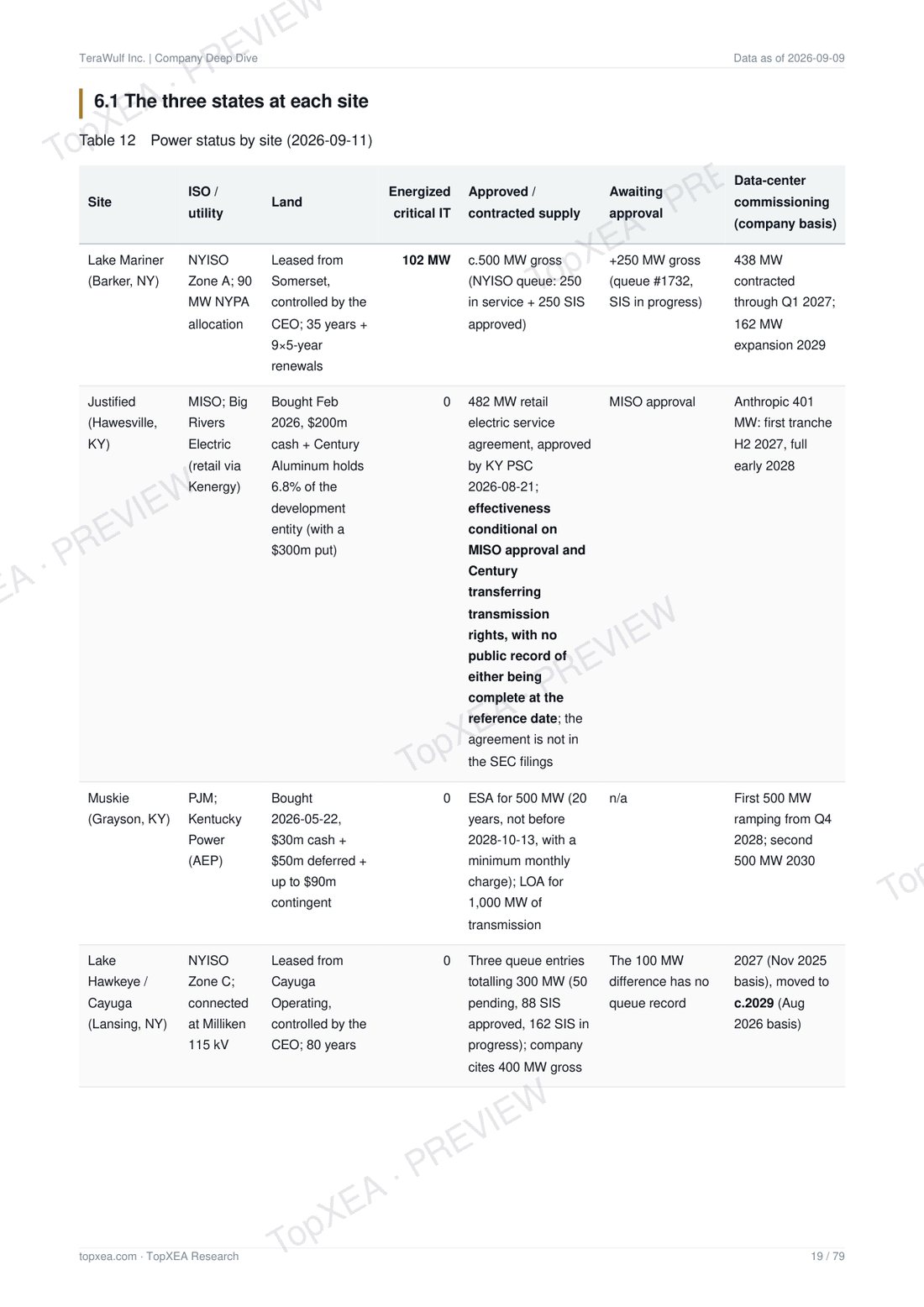

| 6 | Power at five sites: the three 250 MW blocks confirmed in the NYISO public queue; the 482 MW supply agreement in the KY PSC docket and its two conditions precedent; $631m pledged at Muskie with no tenant; what the FERC order actually covers |

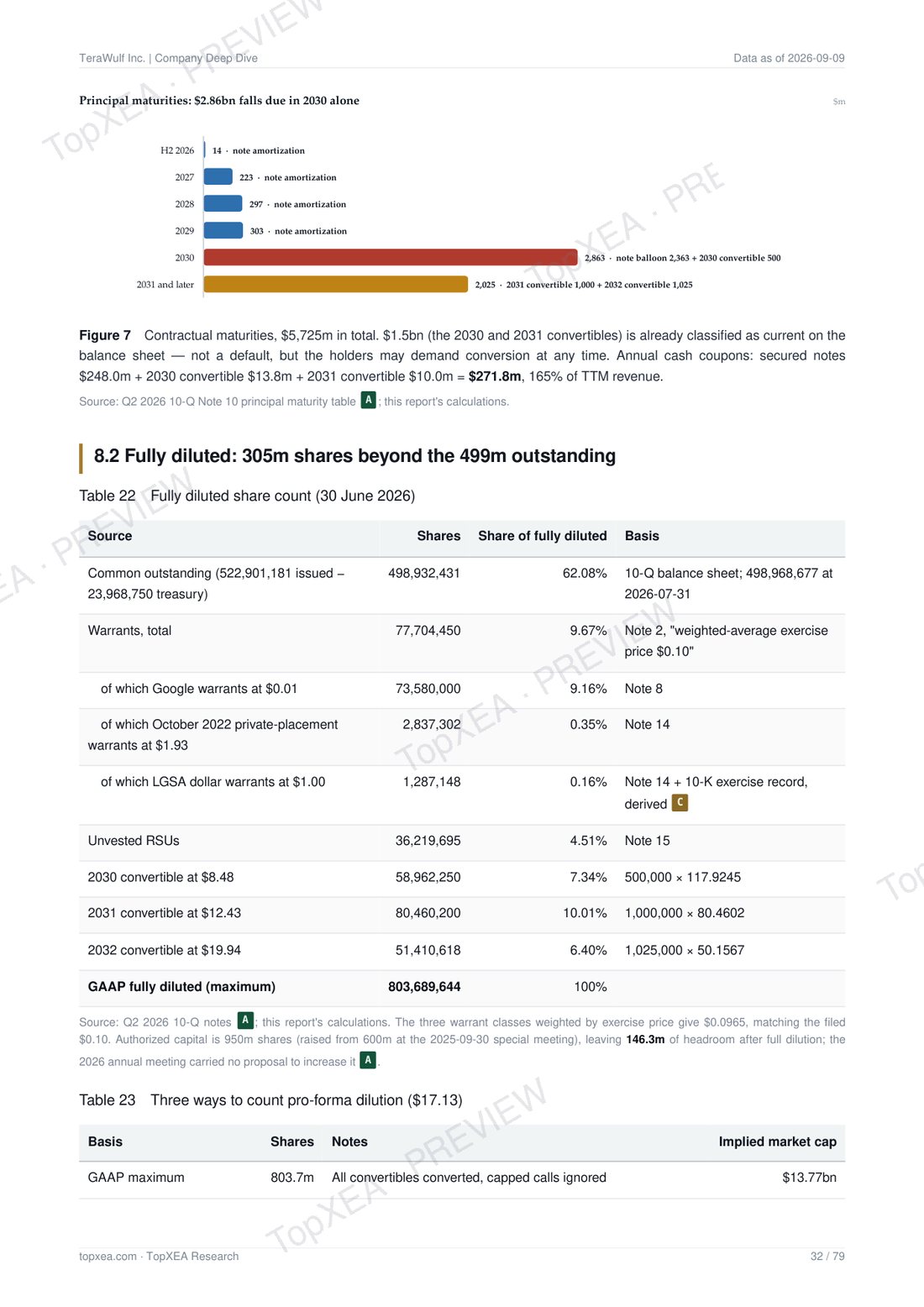

| 7, 8 | Three gross-margin bases; the net-loss-to-operating-cash-flow bridge; SBC at 235% of revenue; debt item by item with maturities; three ways to count 804m fully diluted shares; the funding gap on the company's own remaining-capex disclosure |
| 9 | Ownership, board fit, what pay is tied to, 73 Form 4s transaction by transaction, related-party dealings with the CEO's entities |

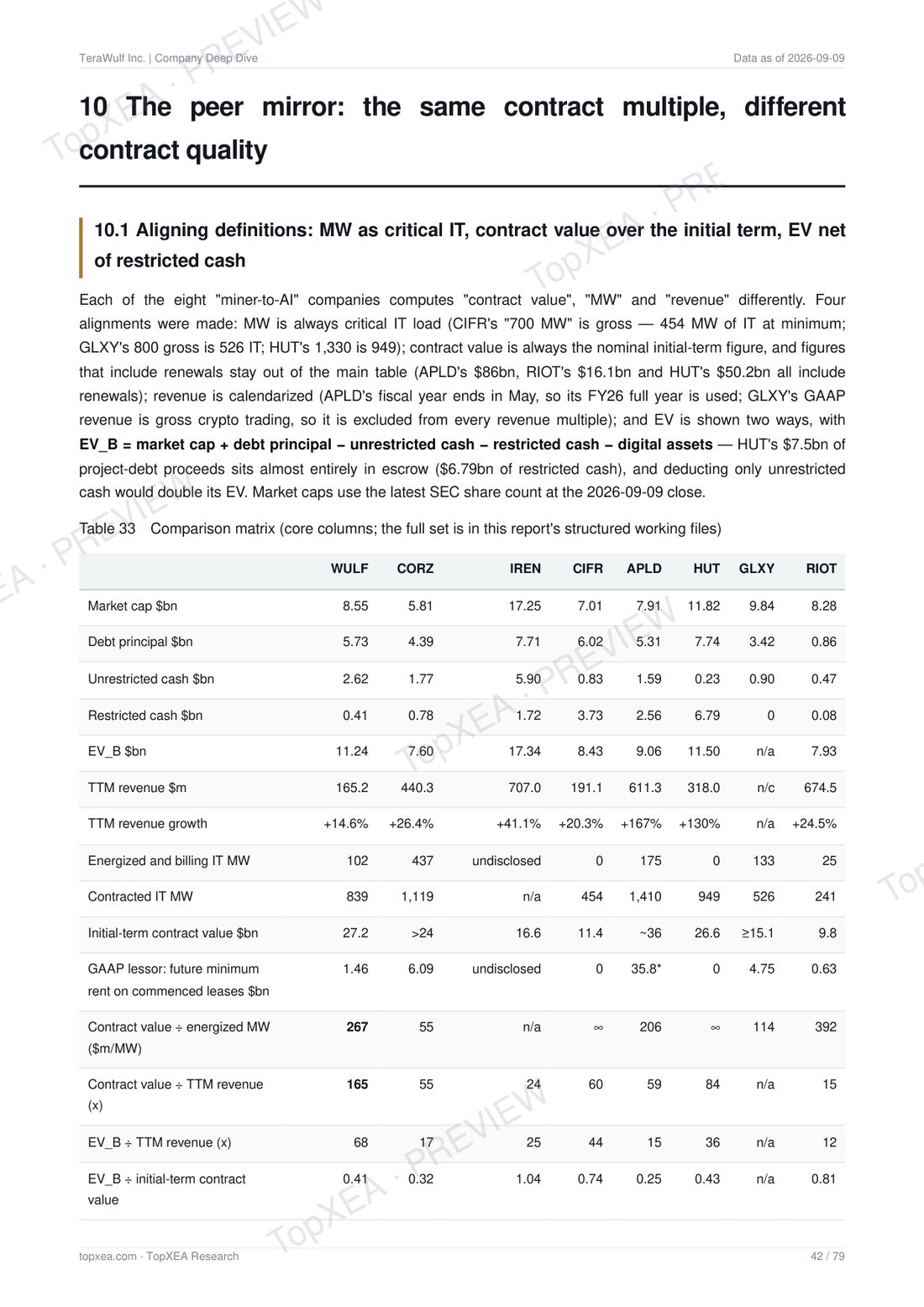

| 10, 11 | Eight peers aligned on one basis; what the price implies, reverse-engineered; short-interest structure, options skew, 13F groups and a factor regression |
| 12, 13 | Two independent valuation paths, a three-scenario price ladder, probability bases against the options-implied distribution, the bridge from spot to target; certainty-layer table, bull/bear comparison, scenario-to-action map, entry and invalidation conditions |
| 15, 16 | Eleven anti-misreading items; falsification conditions, the catalyst path with settlement direction, tracking indicators and the linchpin variable |
Audit and revisions
After drafting, four adversarial audit tracks (financials and valuation / contracts, governance and power / tradability and conclusions / presentation and wording) raised 134 challenges; 25 substantive revisions are published in Appendix C, Table 56. Three deserve stating up front: ① the downside scenario was originally taken from a static DCF that assumed full contract performance — not the downside world — and has been rebuilt; ② the funding gap was originally a rough "un-energized MW × full cost" figure and now uses the company's own remaining-capex disclosure; ③ the description of the Cayuga lease's environmental clause pointed the wrong way and has been corrected to the lease text. The report publishes its own errors.
Sources and verifiability
Primary sources: SEC EDGAR (CIK 0001083301) 10-K, 10-Q, 35 8-Ks with exhibits, DEF 14A, 80 Form 4s, 13D/13G; XBRL companyfacts; KY PSC and FERC dockets; the NYISO public queue; FINRA short-interest data; peer comparisons from seven companies' SEC filings. Every claim carries an [A]/[B]/[C]/[D] evidence grade; 25 known limitations are listed; every computed figure is reproduced with formulas and intermediates in Appendix D.
How this report was produced, and disclaimer
Compiled independently by the TopX research team from public information, then reviewed and revised before release by professional investment managers and fund managers with asset-management experience. Reviewers take part in a personal capacity, do not represent their respective employers, and provide no investment advisory services through TopXEA; TopXEA holds no investment-adviser licence in any jurisdiction. Primary filings (SEC, exchanges, company disclosures) are the first-priority source, key figures require corroboration from at least two independent sources, claims carry [A]/[B]/[C]/[D] evidence grades, and known limitations are disclosed item by item inside the report. This is research content. It does not constitute investment advice and is not tailored to any particular investor; past data and forward projections do not indicate future results. Please note before purchase: digital goods are non-refundable once delivered.
Scorecard
Record period · 2026-09-11 – 2026-09-11All registered calls, verification criteria and revisions are retained. Linked reports may have newer editions; read historical calls with their registration dates and revision notes.
Google's backing strengthens project debt, not shareholder equity: it covers 100% of project debt but only 11.8% of nominal contract value, amortizing to zero with the debt by 2036. The filings contain no executed credit enhancement for Anthropic; the amount is missing from the original record.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
Google or another investment-grade entity provides credit support covering at least 80% of base rent on the Anthropic lease (8-K Item 1.01), or the Lake Mariner recognition agreement is amended so support no longer amortizes with the debt.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
The market does not price WULF's contract-quality differences: EV_B divided by nominal contract value is 0.41, similar to HUT's 0.43. HUT's contracts are 100% investment-grade, while only 26% of WULF's contract value has investment-grade credit.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
HUT's and CIFR's EV_B divided by contract value rises above 1.5 times WULF's ratio, indicating that the market has started differentiating by credit quality.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
The marginal price-setter trades AI infrastructure financing risk rather than Bitcoin beta. After controlling for a peer basket, WULF's partial beta to BTC is near zero across the examined periods.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
During a quiet period with no new contract announcements from Q4 2026 through H1 2027, WULF's partial beta to BTC returns above 0.5 after controlling for a peer basket.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
Only 5.4% of the $27.2 billion nominal contract value is locked in under accounting rules: $1.457 billion of GAAP receivables from commenced leases. The energized 102 MW is 12% of the contracted 839 MW. Realizing the rest requires clearing power, capital and construction hurdles; all three remained open issues on September 11, 2026.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
The lessor table in the February 2027 10-K shows at least $4.5 billion of minimum lease payments receivable on commenced leases, meaning all of CB-4 has commenced, and CB-5's first hall commences in January 2027.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
The contracted but unbuilt 737 MW still requires $5.7–6.5 billion against roughly $3.0 billion available. The $2.7–3.5 billion gap must be filled with more debt or equity issuance. The fully diluted count of 804 million shares versus 499 million basic shares is already locked in.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
The company discloses at least $3 billion of non-dilutive construction funding at a cost no higher than 8% through project-level notes, customer funding or asset sales, and issues no new common shares during 2026.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
Underweight. The 12-month target is $12.3, probability-weighted across $4.0 / $12.1 / $22.7 with weights of 30% / 45% / 25%. That is 28% below the September 9, 2026 close of $17.13; expected relative return versus the S&P 500 total return is below −10%.
12-month horizonLinked report: TeraWulf (WULF) Deep Research — Bilingual Edition- Verification / falsification criteria
Any two of conclusions 1–3 are falsified; or the stock closes above $23 for 20 consecutive trading days and either Anthropic credit support is signed or all of CB-4/CB-5 commences. At expiry, resolve using WULF's price return minus the S&P 500 total return.
- Benchmark / verification source
S&P 500
- Subsequent evidence & revisions
No settlement evidence recorded yet.
Event window, neutral-to-negative. CB-4's first hall commencing (company: end-September), the Q3 print (early November; a c.$560m non-cash warrant gain and a "net income turns positive" headline), the second Abernathy installment of $150m (by 31 December). The options market's three-month ±1σ range is $11.2 to $26.2; put/call ratios of 0.17–0.29 leave little protection in place
- Verification / falsification criteria
Whether CB-4's first hall appears as "commenced" in the November 10-Q
- Benchmark / verification source
Chapter 11 [C]; Table 7
- Subsequent evidence & revisions
No settlement evidence recorded yet.
Two print points: the February 2027 10-K's commenced-lease receivable ≥ $4.5bn (CB-4 fully commenced); CB-5's first hall commencing in January 2027. Watch whether Anthropic's credit support turns into an 8-K Item 1.01
- Verification / falsification criteria
10-K Note 8; 8-Ks
- Benchmark / verification source
Chapters 3 and 6
- Subsequent evidence & revisions
No settlement evidence recorded yet.
Method: every call registered in the period is shown — nothing is selected out. Hit rate = hits ÷ (hits + misses); open calls are excluded from the denominator. Outcomes are judged against the falsification conditions stated in each report. Monthly and quarterly outlooks are settled on the events named in each report's table; they were added to the ledger on 2026-10-13 and carry the report's publication date. Past performance does not indicate future results. Not investment advice.
Your download link is issued automatically after payment (both the English and Chinese PDFs ship in one package) and can be re-downloaded any time from My Account → My Reports.
Reports are delivered as PDFs; the download link is non-refundable once issued — every report ships with free sample pages, so read the sample first. This is research content. It does not constitute investment advice, an offer or a solicitation, and is not tailored to any particular investor's financial situation, objectives or risk tolerance; ratings and target prices are analytical judgments about relative performance, not instructions to buy or sell. Past data and forward projections do not indicate future results.
Further reading
Of $27.2bn in Signed Leases, 5.4% Is Locked In: Where That Number Sits in the 10-Q
Data-center landlords' press releases talk about "contract value"; the accounting standard recognizes only "minimum lease payments receivable on commenced leases". At TeraWulf the two numbers differ by almost twenty times. This piece shows where to find the second one in a 10-Q, why it is harder than contract value, and why the same company reports capacity in two MW bases at once. Reproducible, no paid data.
What Actually Changes an MT5 Backtest — We Ran the Controlled Test
Same EA, same .set, two different equity curves. We isolated the chart timeframe in a controlled test: 60× the bar count, and every figure in both reports came back identical. The variables that actually move the number are elsewhere — ranked by impact, with our own measured data.
Comfort Systems: What Sustained Project Margins Are Worth
A source-backed FIX deep dive: data-center demand, project margins, working capital and the growth required by valuation. Includes a reproducible model.
Ten Straight Quarters of Negative Operating Cash Flow Do Not Mean Mining Loses Money: Three Lines to Read on a Miner's Cash Flow Statement
A bitcoin miner books the coins it mines as revenue, but coins are not cash, and the proceeds from selling them can sit in investing activities. Operating cash flow is therefore negative by construction. Using ten quarters of Riot Platforms filings, this piece lays out three lines to read side by side, and explains why a widely quoted non-GAAP figure swings with the bitcoin price.
